New waste app

Follow Moree Plains Shire on Facebook Follow Moree Plains Shire on Instagram Moree Plains Shire Council on Linkedin You Tube

Redevelopment of the MAAC

Update on Moree’s Aquatic Facilities

At its Ordinary Council Meeting on 20 August 2026, Council resolved several matters relating to the Moree aquatic facilities including, the financial position of the existing facility, Moree Artesian Aquatic Centre (MAAC) and the proposed Taylor Oval Aquatic Precinct.

The decisions made at the Ordinary Council Meeting on 20 February 2025, provide greater transparency around the information Council has considered in planning for the future of aquatic facilities in Moree, while also progressing the next stage of planning for the Taylor Oval Masterplan.

Report On February 2025 Decision Released

In response to a request from Moree Online News and in light of community conjecture around the reasons behind the decision to stop work on the 50m pool at the MAAC and progress Taylor Oval as an alternative option, Council took the unprecedented step of resolving to make a previously confidential report public.

The report from February 2025 was originally considered in closed council due to containing commercially sensitive information. With more than 18 months having passed since the report was considered, some of that information remains no longer commercially sensitive.

Making the report available provides the community with greater insight into the information and recommendations which were provided to the Council at the time, which included increasing costs beyond budget, insufficient contingency, reliance on grant funding and financial and infrastructure risks, including further costs associated with delays, variations and unforeseen issues arising from constructing new infrastructure along ageing existing infrastructure.

The community is reminded that as a historical record, it provides a snapshot in time, which does not necessarily reflect the current stance of the council or associated projects. Ordinarily, the release of this kind of information would have to go through a formal process under the Government Information (Public Access) Act 2009. By resolving to release the report, Council has made it immediately accessible to the community, avoiding the lengthy GIPA process.

The Future of The Moree Artesian Aquatic Centre

As part of the 2026-27 Operational Plan and Budget (Action 1.1.3.9), Council has committed to planning for the future of the MAAC. As part of this work, Council was presented with a report detailing operating costs of over $2m per annum and capital works (both Council and grant-funded) valued at over $1m per annum over the past five years. The report noted that the financial position of the MAAC had been impacted by several factors, including periods of shutdown and significant works across the facility. Council’s existing loans associated with the 2011-2014 reconstruction continue to be repaid with repayments extending through to 2041.

In addition to reviewing costs, Council resolved to undertake further site condition investigations at the Moree Artesian Aquatic Centre, including but not limited to geotechnical, engineering and hydrogeological investigations, with a report to be presented on Council meeting agenda as soon as practicable.

Endorsement Of Taylor Oval Masterplan

Council has thanked the community for its input and feedback on the Draft Taylor Oval Masterplan. Council has endorsed the Stage 1 Plan to progress to detailed cost planning and discussed that further finessing of the Stage 1 Plans will occur during detailed design.

As part of the longer-term Taylor Oval Masterplan, Council has endorsed the inclusion of a Children’s Leisure Pool, Splash Pad and additional shading in Stage 2 as a priority, reflecting community feedback received during consultation. Also, in light of feedback received, Council will undertake a site assessment to explore the potential provision of hot artesian water to the Taylor Oval site.

A report on the Aboriginal Cultural Heritage Assessment for the site is anticipated to also be considered by the Council prior to its review and adoption of the longer term “Vision 2040” Masterplan.

Supporting documents

Business Paper for Ordinary Council Meeting 20 August 2026
Released February 2025 report on the MAAC
Delivery Program 2025-2029 (Update 2026) -  (Action 1.1.3.9) Page 26





Many community members want to better understand the present state of play, what's currently happening at the Moree Artesian Aquatic Centre (MAAC), and why Council is looking at an alternative option for development of the 50-metre pool at Taylor Oval.

This page has been set up to keep you in the loop.

Since 2020, the Moree Plains community has unfortunately lacked a 50m pool, meaning many children have been unable to participate in swimming lessons. Council has responded to the initial issues that led to the demolition of the 50m pool, but additional issues – in particular, leaks – continue to be discovered at the MAAC.

Despite a lot of work to address leaks and other failing infrastructure, there's no guarantee that more leaks won't occur.

There is no perfect answer, but waiting another five years for a pool is not an option. So Council is looking to progress the best available solution.

To stay abreast of future updates, bookmark this page and stay tuned to Council's Facebook.

Background to the MAAC and the 50m pool

The history of the MAAC provides context for some of the current issues.

  • 1913 – the original six-lane, 60-yard pool was built.
  • 1965 – the Freedom Ride and protests occurred at the MAAC in February 1965, leading to a National Heritage Listing.
  • 1977 – facility improvements, with the addition of some of the brick buildings and amenity facilities, as well as the two open-air hot pools.
  • 2011 – extensive redevelopment of the facility, with the demolition of all existing pools to develop:
    • a new eight-lane, 50m outdoor pool.
    • the program pool.
    • the children's splash area.
    • the installation of new water filtration systems.
    • the construction of two new hot spa pools.
    • the conversion of the eastern wing and the enclosed hot artesian pool into the gymnasium, café, and administration offices.
    • the conversion of the western wing and the reconfiguration of the enclosed artesian pool into the Wellness Centre.
    • construction of the water slide.
  • 2012 – issues and defects with the redeveloped MAAC emerge.
  • 2020 – the 2011 50m pool was decommissioned and eventually demolished due to structural failure.
  • 2023-24 – The program and wellness pools were refurbished and the splash park was removed due to water leaks.
  • 2024 – construction of a new 50m pool, grandstand and associated earthworks commence, with a review of environmental factors.
  • 2025 – refurbishment of the passive and active hot pools.



Other critical issues at the MAAC

  • Incorrect pipe sizes and fittings have been applied – both by trying to fit incorrect sized pipes to existing pipes, as well as the use of pipes and other infrastructure that didn't meet required standards.
  • The plant was due to be replaced in 2016, but continued to operate, resulting in failures that saw SafeWork NSW close the facility in January 2025 to address issues with pumps and pipelines for the transfer of chlorine and hydrochloric acid, leading to the installation of a new chlorine storage tank.
  • General deterioration of the facility’s equipment, including switchboards, controllers, and pumps that have passed their functional service life.
  • Failed sand filters, hot water systems and showers as recently as July 2025.
  • The closure of the program pool in December 2024 due to a filter failure.
  • Overall failure to adhere to the asset maintenance and replacement schedules, contributing to resourcing and budgetary constraints.



Leaks

Multiple pools, buildings and facilities leak, with investigations resulting in further leaks being found.

  • Earthworks for the new 50m pool commenced in March 2024, but were halted shortly after excavation commenced, as the contractor thought they'd hit an underground spring due to the volume of water found. Analysis showed it to be artesian water, which highlighted that the leakage is from the MAAC. The presence of this water meant earthworks had to halt.
  • The artesian leaks contributed to toilet, change rooms, pipe work and fitting failures (although some of this is also associated with movement of the existing buildings). This has caused waterproofing of amenities to fail, contributing to leaking under the buildings housing those facilities.
  • The 2011 active and passive hot pools were built inside the shell of the 1913 pool, having retained the concrete slab underneath, with topping slab poured that has since been found to be of poor quality. This contributed to a substantial amount of the leakage, however this was not evident until these pools were demolished. Both the active and passive hot pools are in the process of being rebuilt.
  • The newly constructed Wellness Centre was also leaking water, undermining its foundations.
  • Further leak detection undertaken in early 2025 found the decommissioned children’s splash area had been leaking water for three years because one of the pipes servicing it had not been capped properly.

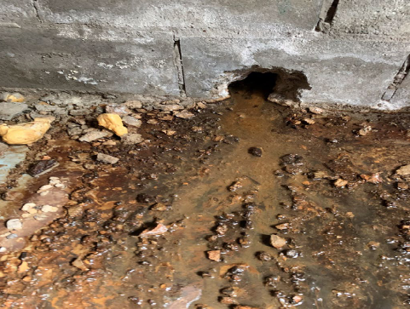

  • As of August 2025, an active leak continues underneath the MAAC, which is apparent around the splash pad area.
  • One of the ongoing risks is ground movement, contributed to by leaks under the buildings, leading to a need to reroute drainage.
  • A heavy storm event in 2024 presented roof leaks, the roof having bowed due to the weight of the solar panels installed.

Council has engaged plumbing services to investigate, a process which sees each element investigated one by one to eliminate them as a source of leak. Complicating this task is an absence of accurate drawings from the 2011 redevelopment – a result of both poor filing and staff turnover.

Leak investigations have also been delayed due to the need to undertake maintenance work on hot-water systems, wet areas, change rooms, as well as pumps and other facilities.



Addressing these issues
Roejen Engineering Services provided Council with an asset condition report in December 2024.

Trisley’s Hydraulic Services are improving equipment maintenance and supporting local contractors.



Remaining financials

Grant money for the project is specifically for a 50m pool, grandstand and tiered seating, the result of the following generous grant funds:

financials

  • Approximately $10 million from the Australian government.
  • Approximately $8 million from the NSW government.
  • Approximately $5 million from Council.

Some of this amount has been spent on work at the MAAC, while most of the rest is approaching expiry, so Council will submit variation requests to the relevant government agencies to extend this funding.



Financial considerations for a new site

With the construction of a new 50m pool expected to cost tens of millions of dollars, and considering the length of time spent already to try and progress works at the MAAC, the ongoing difficulty of locating leaks and the costs to fix the issues, Council has resolved to consider an alternative site that provides some cost preservation and value for public money.

The new site needs to be:

  • Owned by Council, so additional funding to purchase one (which cannot be covered by grant funds) is not required.
  • Flood free, because building a pool at risk of frequent flooding requires additional construction, which elevates costs.
  • Zoned appropriately and offers sufficient space for current and future needs, as well as being located close to the schools who would benefit from its use for both school carnivals and learn to swim programs.

Taylor Oval meets all these considerations.



Why Taylor Oval?

Taylor Oval is a recreation sporting precinct, with existing tennis facilities, so installing with the 50m pool is consistent with the historical use of the precinct. Further, a pool at Taylor Oval will bring both locals and tourists to the town centre, contributing to the redevelopment of Balo St.

From a financial perspective, a pool at Taylor Oval helps contain the costs.

The first time Council went to market, the only tenders received were from companies that had not built a pool before, making these tenders unacceptable.

Going back to market to call for new tenders, not one builder wanted to take on the whole project – they wanted it split up:

  • Earthworks and piling as one project and contract
  • Building the pool as a separate project and contract
  • Concreting to be another project and contract

That's not normally what happens when you go out to market for a pool and was due in large part to the complexities of the MAAC site and the constraints of having to work around residential building.

These complexities do not make for a particularly appealing business proposition, so Council had less competition for the job – and less competition can often mean paying a higher price.

As a greenfield site where contractors do not need to work around existing infrastructure, Taylor Oval presents as a more attractive project, leading to greater competition.

History of Taylor Oval

  • 1892 – first officially designated a sporting precinct, leading to the site becoming the pre-eminent Oval within Moree.
  • 2005 – Council adopted a Sports Facilities Strategy, as a result of a report by Thompson Tregear that found Taylor Oval did not meet the requirements of a premium sports facility, seeing a shift towards Ron Harborne Oval.
  • 2007 - Taylor Oval was entered as a burial site on the Aboriginal Heritage Information Management System (AHIMS).
  • 2011 – Taylor Oval is listed as a place of Aboriginal cultural significance in Moree Local Environmental Plan.
  • 2011 – the State Government supported a change in the zoning of Taylor Oval from a recreation zone to a commercial zone (redeveloped as an aquatic facility is a permissible use both in a commercial and a recreation zone).

Feasibility of Taylor Oval

Council engaged NSW Public Works on 21 March 2025 to undertake a feasibility study into the construction of a facility at Taylor Oval containing:

  • 50 m pool.
  • Covered grandstand and 2 x 10 m covered seating areas.
  • Two-storey amenities building including change rooms, amenities, storage area and club room with deck.
  • Plant room and plant equipment.
  • Service desk and entry foyer.
  • Security fencing with access control.
  • Concreted pool surrounds and pathways.
  • Car park for up to 30 vehicles.

The study found: “Taylor Oval is a suitable location for the proposed new pool given its connectivity to the town centre, its proximity to the existing sporting and community infrastructure and the local schools. It also affirms that construction is feasible, pending the completion of the design and engineering phases, including further detailed site investigations.”



The Aboriginal Heritage Information Managament System (AHIMS) listing

As per the Heritage NSW feasibility study, extensive work has already been undertaken in regards to Taylor Oval’s heritage, such as: “historical research including parish maps, oral histories, electro-magnetic subsurface imaging and a substantive program of subsurface test trenches”, which led to the conclusion, “it seems unlikely that Taylor Oval… was a specific location used as a traditional Aboriginal burial ground”.

As per the recommendation of NSW Public Works, Council has requested that Heritage NSW reviews the AHIMS listing in light of prior findings.



What has Council resolved to do?

The feasibility report prepared by Department of Public Works NSW was presented to Council at the Ordinary Council Meeting on 17 July 2025.

The report had the following scenarios:

  • Scenario 1: If Heritage NSW approves Council's request for the review of the Taylor Oval site listing – a process that generally takes 60 days – a report will be brought to Council to consider concept options for construction and seeking endorsement for undertaking grant funding variation request to complete the project.
  • Scenario 2: If Heritage NSW denies the request, a detailed archaeological investigation of Taylor Oval will be required. This is expected to take at least 40 weeks, during which time there be no construction occurring at Taylor Oval.

Council resolved to note the report for information and proceed with Scenario 1.



Concept site plans prepared by public works

Blueprint plan of Taylor Oval

Blueprint plan of Taylor Oval
These are early plans – not final designs – that illustrate how a 50m pool could sit on Taylor Oval.



Next steps

Pending advice from Heritage NSW, Council will progress project planning for the 50m at Taylor Oval, including consultation with the community with regard to:

  • The short term concept and detailed designs for the site, including exactly what infrastructure is proposed to be built at Taylor Oval and how other uses for the site can be incorporated (such as car-parking, SES operations during flood events, green space and acknowledgement of cultural/historical significance);
  • The long term master plan for the site;
  • Investigation into the artesian water connection at the site.





Reinstating One Of The Key Jewels In The Moree Plains Crown

General Manager Natalia Cowley and Mayor Susannah Pearse with Councillors look forward to welcoming the community back to the famous hot pools at the MAAC WMoree Plains Shire Council Mayor Cr Susannah Pearse, with fellow Councillors and General Manager Natalia Cowley, had the great pleasure of cutting the ribbon at the Moree Artesian Aquatic Centre (MAAC) on Thursday, 9 April 2026, celebrating the re-opening of all the artesian hot pools.

“Today is an incredibly exciting day for our community. Witnessing the joy in the faces of families and visitors taking in the waters has been such a reward for our Councillors and team, following the reinstatement of one of the key jewels in the Moree Plains’ crown,” said the Mayor, Cr Susannah Pearse.

“The artesian water has been a part of Moree’s identity since 1895. The love of artesian water and its thermal properties is a world-wide phenomenon, and we are so very lucky to have it here, beneath our feet, and now, back for people from all over the world, or just down the road, to enjoy,” said Mayor Pearse.

“Being without our full complement of artesian facilities for some years has been frustrating for our community, and also for our tourism industry.

“We know the return of tourists, ahead of what is actually the busiest period for that market, is going to reinvigorate our local businesses as a time when that is much needed.

“It’s why we knew these artesian baths had to be a priority.

The Mayor acknowledged that there is still more on the to-do list but said that “today demonstrates that we are a council that can, and will, get the job done.”

Council’s General Manager Natalia Cowley thanked Project Manager David Mangelsdorf and the many local and regional contractors for delivering for the community, acknowledging “this has really been a huge team effort utilising both specialist and local expertise.”

“Thank you to our team and all of our contractors for their hard work in delivering for our community.”

In celebration of the reinstated facilities, the MAAC is offering 4 weeks free and $0 joining fee on Bronze Swim Only and Silver Swim + Classes memberships (available for a limited time only)
https://www.moreeartesianaquaticcentre.com.au/join/memberships-passes

The MAAC is open daily from Monday to Friday 6am to 7pm Saturday and Sunday 8am to 6pm.

The MAAC Hot Artesian Pool Redevelopment project has been made possible thanks to funding from:
• NSW Government’s Stronger Country Communities Fund (SCCF) Round 5 - $892,000
• Commonwealth of Australia’s Local Roads and Community Infrastructure (LRCI) Program Round 4 - $675,000;

In addition to Council funding of $1,656,000

Watch the NBN news broadcast

Image - General Manager Natalia Cowley and Mayor Susannah Pearse with Councillors at the official re-opening of the hot artesian pools at the Moree Artesian Aquatic Centre (MAAC)







Mayor Calls On Community To Celebrate With A Free Day At The Moree Artesian Aquatic Centre

General Manager Natalia Cowley and Mayor Pearse look forward to welcoming the community back to the famous hot pools at the Moree Artesian Aquatic Centre WMoree Plains Shire Council’s Mayor Cr Susannah Pearse is throwing open the gates with everyone invited to a free entry day at the Moree Artesian Aquatic Centre (MAAC) from 10.30am on Thursday, 9 April 2026.

“After many months of hard work, I am proud to announce the reopening of the Passive and Active hot artesian pools at the MAAC.

“I would like to thank the community and pool users for their patience and understanding while these works were being completed. Councillors and I are thrilled to have the community back at the famous hot pools and I thank
Council’s General Manager Natalia Cowley and her team for all their hard work on this project.

The artesian pools at the MAAC are an integral part of our community, and a popular spot for tourists and locals to relax and rejuvenate, so to have them out of action for this extended period of time has been frustrating,” acknowledged Cr Pearse.

Ms Cowley thanked the specialist local and regional contractors who have been so hard at work at the MAAC - O’Neill Concreting, DD’s Engineering and Fabrication, Level Plumbing Tamworth, Crawford Constructions, along with Roejen Services.

“Importantly, we thank the State and Federal Governments for their financial support in this project for their combined grants of $1.567m, along with Council funding of $1.656m to make this a total $3.223m spend since 2023,” said Ms Cowley.

From 10.30am onwards, everyone is welcome to come and experience the newly refurbished pools, with free waterslide use from 10.30am to 1.30pm. The Wellness Pool will revert to its original intent as a private booking space from 10.30am 9 April 2026.

The Moree Artesian Aquatic Centre is operational daily from Monday to Friday, 6am to 7pm, Saturday and Sunday, 8am to 6pm.

Image – General Manager, Natalia Cowley and Mayor Pearse look forward to welcoming the community back to the famous hot pools at the Moree Artesian Aquatic Centre.





Project Update - Moree Artesian Aquatic Centre (MAAC)

This week, works have continued across both the Active and Passive Pools at the MAAC.

At the Active Pool, extensive piping and electrical conduit installations are underway around the pool perimeter, with preparations being finalised for upcoming concrete works over the piping and conduit. The construction of a shade structure is underway. This structure will assist in managing temperature impacts on the concrete by reducing direct sunlight exposure during the curing process.

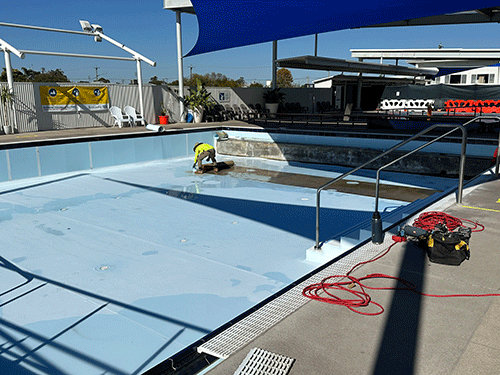

Over at the Passive Pool, a new concrete pour has also been completed on the pool steps and seating.

Cocreate pour on the steps of the Passive PoolExtensive piping and electrical conduit installations around the Active Pool





Project Update - Moree Artesian Aquatic Centre (MAAC)

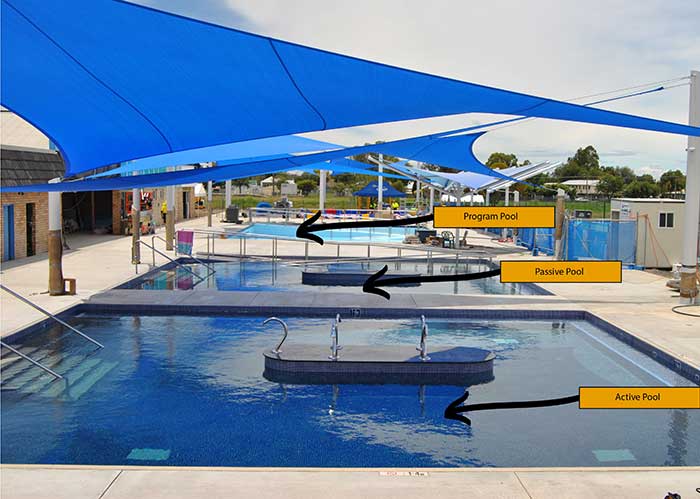

Program Pool Update
We’re excited to share that the Program Pool has been refilled and is currently undergoing manual chlorine dosing to meet the required water quality standards and further cleaning.

We expect to reopen the Program Pool next week. As soon as we have a date, we will let the community know.

MAAC Program Pool





Project Update - Moree Artesian Aquatic Centre (MAAC)

Passive Pool

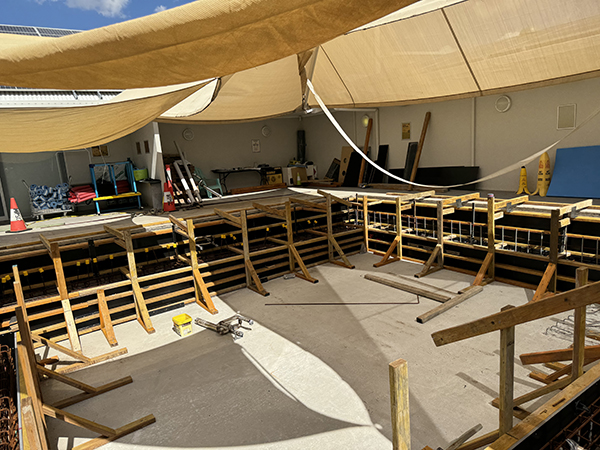

A further update on the remediation works at the MAAC, today saw the concrete slab poured in the Passive Pool. Once stabilised, the concrete will take a further 28 days to cure and set.
Active Pool
Plumbing works continue in the Active Pool with durable, fit-for-purpose poly piping.
Program Pool
Since the implementation of the new filters, work on emptying approximately 118,00 litres of water from the Program Pool is being undertaken.

The pool will be refilled tomorrow, with the balance tank cleaned out. Once thorough testing has been completed, we will advise the community of its opening.

Again, thank you to Marty O’Neil, Level Plumbing Tamworth, along with the Roejen team. More importantly, we thank the community for your patience and understanding while these works are being undertaken to bring back this long-awaited community facility.

Images - Passive Pool

Moree Artesian Aquatic Centre_Passive PoolMAAC 11 4

Active Pool

MAAC 11 2Moree Artesian Aquatic Centre_Active Pool

Program Pool

MAAC 11 5MAAC 11 7





Project Update - Moree Artesian Aquatic Centre (MAAC)

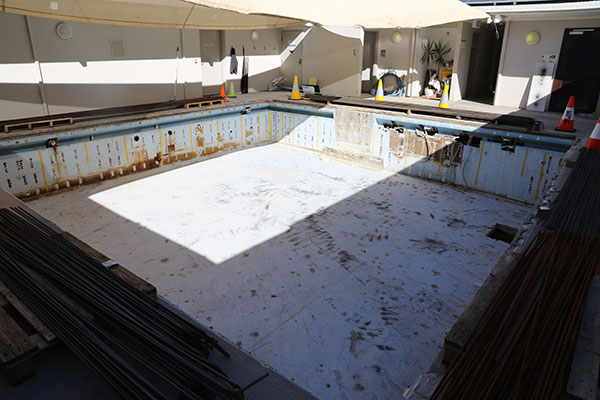

We’re excited to share some great progress on the long-awaited redevelopment of the Moree Artesian Aquatic Centre.
Passive Pool
A brand-new project team is now on site and specialist local and regional contractors have been engaged to complete the Passive Pool works. A huge thanks to Crawford Constructions for clearing 18 truckloads of rubble and setting the stage for the next big milestone, a new concrete pour by Marty O’Neil and his team next week.
Active Pool
Work is also moving ahead on the Active Pool. Level Plumbing Tamworth has completed the replacement of the steel pipes with durable, fit-for-purpose poly piping and is connecting all the new plumbing for both pools in line with design specifications. A special thank you to our project team, David and Mark, for keeping everything on track, safely, efficiently and on budget. After years of waiting, it’s great to see this project gaining strong momentum.

Stay tuned for more updates as we bring this long-awaited community facility closer to completion.

Passive Pool at the Moree Artesian Aquatic Centre MAACPassive Pool at the Moree Artesian Aquatic Centre MAAC

MAAC W3Passive Pool at the Moree Artesian Aquatic Centre MAAC





Project Update - Moree Artesian Aquatic Centre (MAAC) - October

Work is progressing well at the Moree Artesian Aquatic Centre (MAAC) as part of the ongoing upgrade program. Around 70 tonnes of concrete have already been removed from the Passive Pool, marking another major milestone in the project.

The safe removal of a small section of external asbestos at the clubhouse has been completed, and further work on the reinstatement of the cantilever beam and removal of temporary post support over the change rooms is underway to ensure public safety.

We’re also pleased to share that new filtration pumps, an important part of keeping the pools running smoothly, have been delivered and installed. This upgrade, representing an investment of almost $100,000, will allow us to drain, clean and recommission the Program Pool. Once that process is complete, the waterslide will return to operation.

The Program Pool is expected to reopen by the end of November, and we are excited to be getting closer to welcoming everyone back.

A huge thank you to the community for your patience and understanding as we continue these important works to restore the MAAC experience for everyone.

Images - General Manager Natalia Cowley, Mayor Cr Susannah Pearse, Deputy Mayor Wayne Tighe, with Project Manager David Mangelsdorf.

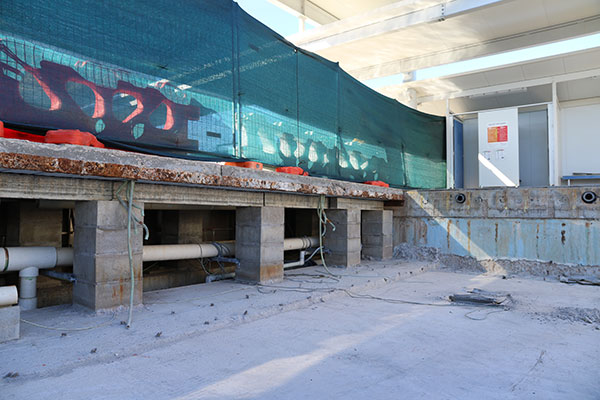

New filtration pumps.

MAAC 22 6MAAC 22 1

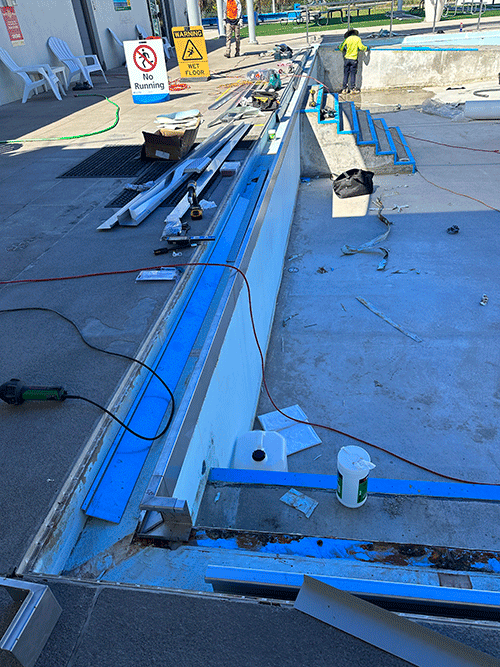

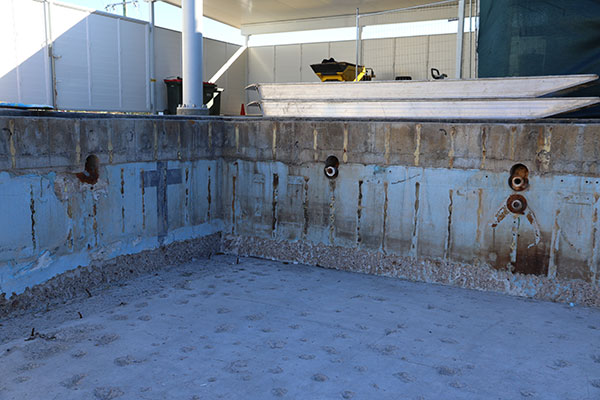

Reinstatement of the cantilever beam.
Active Pool with durable, fit-for-purpose poly piping.

MAAC 22 3MAAC 22 4

Active Pool is being fitted with durable, fit-for-purpose poly piping.

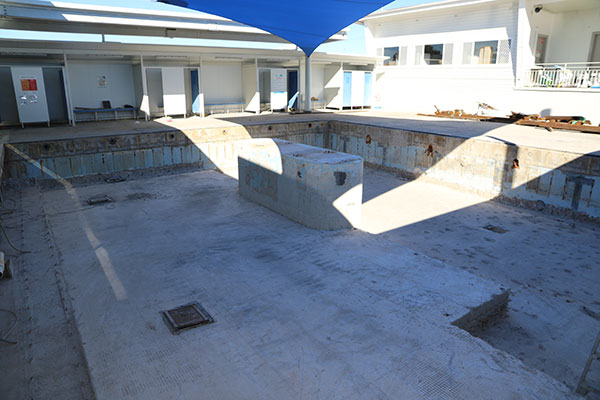

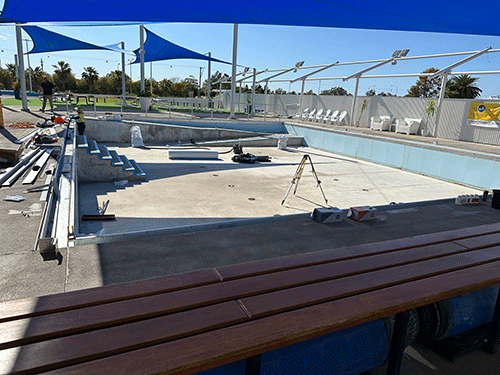

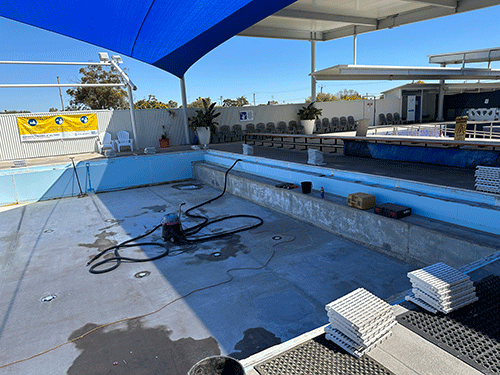

Overview of the Pools

MAAC 22 5MAAC 22 2





Service Interruption at The Moree Artesian Aquatic Centre (MAAC)

We wish to advise that due to significant faults on two existing sand filters servicing the Program Pool at the MAAC, the Program Pool will be inoperative for approximately 12-14 weeks.

The filters have been assessed, and it has been determined that new filters will need to be ordered and built off-site before being delivered back to Moree.

We understand the inconvenience caused to users of the Centre, and we appreciate the community's understanding as we work towards re-opening the Program Pool as soon as possible.

We will continue to keep the community informed on this matter.





Recording - Community briefing and Q&A on 50-Metre Pool

Council held an online briefing session for the community on Wednesday, 30 July 2025, via Microsoft Teams.
A recording of the briefing is available below.







Update: Moree Artesian Aquatic Centre - Program Pool

Assessment of the Program Pool filters at the MAAC has revealed faults in the two existing sand filters, including broken seals, laterals and underdrains due to their age and condition.

These faults have caused sand to discharge into the pipework, pool jets, and the pool itself. The sand also caused damage to the heat exchangers and the heating boost pump.

To address this, the program pool needs to be emptied of approximately 118,00 litres of water and the sand removed by vacuum.

The filtration lines will then need to be continually flushed until all of the sand has been removed from the system.

To minimise the time that the program pool is closed, Council is investigating the options of both repairing and replacing the damaged filters.

Noting that suppliers have advised Council that the replacement sand filters currently have a lead time of 12–16 weeks from the date of order.

We thank everyone for their patience, and we are sorry for the inconvenience. We are doing our best to minimise community impact. Unfortunately, this isn’t a simple or quick issue to resolve, and we will provide the community with updates as soon as we have more information.





Progress Update: Moree Aquatic Centre

Taylor Oval MoreeAt the July Council meeting, held on 17 July 2025, a resolution was passed that Moree Plains Shire Council proceed with Taylor Oval as the planned site for the new Moree Aquatic Centre.

During the meeting, a report from NSW Public Works regarding Site Feasibility for Taylor Oval was presented to Council.

The report confirmed, “Taylor Oval is a suitable location for the proposed new pool given its connectivity to the town centre, its proximity to the existing sporting and community infrastructure and the local schools.”

Moree Plains Shire Council Mayor, Cr Susannah Pearse, said the study was a step in the right direction, one that allowed Council to continue with existing plans for Taylor Oval as the site for the new pool.

“This study concluded that Taylor Oval is a suitable and feasible location for our new swimming pool, which is really positive,” said Cr Pearse.

“Council is aware of how passionate our community is about our pool and how important it is to have somewhere to swim – especially for children who are learning this vital life skill – so we are pleased to Taylor Oval Moreehave a number of scenarios to ensure Taylor Oval moves forward as the site.

“In terms of next steps to getting final approval for Taylor Oval as the site for our new pool, the report from NSW Public Works recommended Council consult Heritage NSW and we will proceed based on that recommendation.”

In considering the matter, Council noted the extensive work undertaken in reviewing the site’s cultural heritage – which resulted in the state-approved rezoning more than a decade ago – and has requested that Heritage NSW consider that prior work in a review of the current registration.

If Heritage NSW approves Council's request, next steps will be to undertake additional engineering investigations and consider concept options for design of the new pool.

Images - Taylor Oval, Moree.





Council Announces Strategic Shift for 50m Pool

Mayor-Susannah-Pearse-and-Deputy-Mayor-Wayne-Tighe-on-site-at-the-MAAC_W.jpgMoree Plains Shire Council has undertaken a strategic review of the Moree Artesian Aquatic Centre (MAAC) redevelopment, ultimately identifying that it is time for a new home for Moree’s 50m pool.

“We are deeply sorry for the length of time it is taking to deliver the 50m pool at the MAAC,” said Mayor, Cr Susannah Pearse.

“We know the community is beyond frustrated.

“Council has taken its obligations to the community seriously, to not only deliver necessary community infrastructure, but also set the region up for long term growth and liveability.

“We have considered the challenges faced at the current site over many years, weighed up the options, and in turn, agreed that it is time to let common sense prevail and look at a new site - one which has also been talked about in the community for some time.”

As such, Council resolved at the Ordinary Council Meeting 20 February 2025 to halt works on the current 50m MAAC site and proceed with a feasibility study for Taylor Oval.

“This decision reflects the Council’s consideration of key factors such as providing high quality and value for ratepayer money infrastructure, driving CBD activation, fostering tourism and economic development, supporting future population growth, and addressing the current needs of our residents.

“While changing course may be challenging, it is a necessary step to ensure the long-term viability and sustainability of this vital community asset,” said Cr Pearse.

In its deliberations, Council also considered the future of the MAAC, noting its historic significance and value to the tourism industry. Cr Pearse reassured the community that “Council is committed to planned improvement works to the hot artesian pools at the MAAC”.

“As part of our review, Council will be exploring the best options to keep the important tourist attraction and significant community asset open.”

Cr Pearse applauded the recently appointed Council in strategically tackling the big issues early on, remarking that “this was not an easy call for the council to make. But it is the right call.”

Image - Mayor Susannah Pearse and Deputy Mayor Wayne Tighe are on site at the MAAC where the 50m pool once resided.



Moree Artesian Aquatic Centre (MAAC) to Reopen on Saturday, 1 February 2025

We are pleased to announce that following essential upgrades and repairs at the Moree Artesian Aquatic Centre (MAAC) the program and wellness pools will reopen tomorrow, Saturday, 1 February 2025, at normal hours from 8am to 6pm. The reopening follows a closure beginning Tuesday, 7 January 2025, due to a failure in aging equipment in the plant room.

General Manager Natalia Cowley expressed her gratitude to the local contractors, businesses and other suppliers involved in this essential maintenance project. "I would like to thank the contractors and businesses who worked diligently to ensure the successful completion of this important upgrade," she said. "We also want to thank the community for their understanding and patience throughout the closure, and we are excited to welcome everyone back to the pools."

The closure allowed for the installation of new chemical tanks, a chemical dosing recirculation system, dosing pumps, and upgraded pipe work, fittings and valves.  SafeWork NSW has also lifted the prohibition notices, confirming the upgrades meet all necessary safety requirements.

The completion of these upgrades ensures the safety of staff and visitors and we look forward to welcoming everyone back to enjoy the MAAC.





Moree Artesian Aquatic Centre (MAAC) Update; Re-opening of the Pools

Following the closure of the pools at the Moree Artesian Aquatic Centre (MAAC) on Tuesday 8 January 2025, we would like to update the community on replacing the failed equipment. The chlorine tanks were delivered last week and the installation completed.

Four new chlorine pumps and piping have also been purchased, however, due to transport logistics delays, unfortunately the materials that Council anticipated to arrive last week will now be delivered this week. This delay has impacted the timeline for the full reopening of the facility.

We are now working towards the re-opening of the aquatic side of the MAAC after the Australia Day long weekend.

Acting General Manager Darryl Fitzgerald expressed his appreciation of the endeavours by council staff and local contractors and businesses to reopen the pools. “We acknowledged the community's understanding as we work diligently with SafeWork NSW to have the Centre up and running as soon as possible.”

Access to the gym and café continues to remain available.





Moree Artesian Aquatic Centre (MAAC) Temporary Closure Update

Following the unexpected closure of the Moree Artesian Aquatic Centre (MAAC) on Tuesday, 8 January, due to a prohibition order issued by SafeWork NSW, we are working on reopening the facility in the week commencing 20 January 2025.

Council has been working closely with SafeWork NSW to ensure the ongoing operation of the MAAC, despite challenges posed by aging equipment. Unfortunately, the equipment reached the end of its life before we could complete the planned redevelopment of the new plant room.

We are pleased to announce that we have secured the services of Colonial Chemical to assist with the installation of the tank fit-out, pipework, and temperature system.

We apologise for the inconvenience caused to our valued patrons. Please know that in the interest of public safety, we must comply with the improvement notice. We are doing everything possible to reopen the pools as soon as we can. Access to the gym and cafe will remain available.


Image – The Moree Artesian Aquatic Centre (MAAC) entrance.





Pool entry at the Moree Artesian Aquatic Centre (MAAC)

Council resolved at its Standing Committee Meeting, Thursday 5 December 2024 to amend the fees and charges for pool entry at the Moree Artesian Aquatic Centre (MAAC) back to those set out in the 2024/25 Operational Plan and Budget.

This change to the fees will commence on Monday, 9 December 2024.

Per Section 610F (3) and 705 of the Local Government Act 1993, Council discounted the swim entry fee to the MAAC to a casual entry fee of $2.00 per person in August 2024, to encourage attendance while we were unable to offer a fully functioning complex to our users.

Security is and remains an important part of our facility for patrons and staff. However, due to the ongoing need for security and this added and unbudgeted cost to Council, continuing with a discounted fee at the pool is no longer feasible.

Council and Belgravia do not condone violence and anti-social behaviour in any of our facilities and ask the community to be respectful of each other and our staff.

While the complex has encountered challenges, we continue to work towards delivering this project back to the community.





Annual Pool Close Down at the Moree Artesian Aquatic Centre (MAAC)

Map of the MAAC We would like to advise that the annual pool closure at the Moree Artesian Aquatic Centre (MAAC) will take place from 29 to 31 July 2024.

The annual shut down will allow Belgravia Leisure to complete regulated works before reopening on 1 August.

Parallel to the regulated works being completed, Council continues to work on remediation/upgrades within the Centre to the passive and active artesian pool(s).

Upon reopening in August, the passive pool will be closed for refurbishment and shortly thereafter the wellness pool will come online as the public artesian pool, offering Patrons an alternate artesian experience.

Unfortunately, there will be a short period where no artesian pools are available, while this changeover occurs.

From 1 August 2024 entry to the pool will be charged a $2 for all aquatic users (excluding the waterslide and aqua programs).

These changes will not affect the Aqua Movers’ program as this will continue to be facilitated in the program pool.

Once the wellness pool opens, due to its size, there will be a 30 patron limit at any one time.  To address capacity issues, we will be running one hour booking slots for patrons who wish to soak in the artesian water.

To help facilitate this, bookings can be made with Belgravia Leisure on (02) 6752 2272.

During this time, we cannot take group bookings for the wellness pool.

 The changes at the MAAC will bring into effect:

  • $2.00 entry fee for everyone over 5 years of age (excluding aquatic programs, gym/fitness and slide fees).
  • During the redevelopment of our outdoor artesian pools all Aquatic Memberships will be on hold.
  • 30 patron and one hour session limit in the wellness pool.
  • We encourage all patrons to call and make bookings for the wellness pool, to avoid disappointment.

The MAAC will recommence under the same operational times of Monday to Friday 6am to 7pm and Saturday and Sunday 8am to 6pm.

General Manager Kelvin Tytherleigh acknowledged “that the continual works do see interruptions and we understand that the Centre not running at full capacity, therefore, we have reduced the pool(s) entry fee to a flat $2.00. Council appreciates the community’s understanding as we continue to work on the redevelopment of the MAAC”.
